Case study 01 · Cat B office fit-out · Central London · £1m – £2m

Two floors, three prices, four days

A Cat B office fit-out on a landlord’s retained Cat A shell — 1,380 m² NIA for 130 desks plus a social half-floor — priced at three tiers from two feasibility layouts and a marketing brochure. No specification, no bill of quantities, and no confirmed floor.

1,380 m²

NIA over two floors

4 days

Brief to issued pack

24

Trade sections

3

Priced tiers

The Brief

What arrived — and what didn’t.

Document Status Note
Designer feasibility layout — full office floor Received One PDF sheet. Desks, meeting rooms, IDF/MDF, tea points.
Designer feasibility layout — social half-floor Received One PDF sheet. Kitchen, training, games, bleacher.
Building marketing brochure Received 57 pages. Used for the base-build specification and the schedule of areas.
Specification Missing None. Finishes, partitions and the M&E basis all had to be assumed, and every assumption stated.
Bill of quantities Missing None. Every quantity measured in-house off the two layouts.
Per-room areas, window lengths, floor-box and light-fitting counts Missing Not derivable from what was issued — logged as clarifications rather than guessed.
Floor number Missing Never fixed. Priced floor-agnostic, since the upper plates are identical.

The ask. A Bronze, Silver and Gold budget for the fit-out package only, sitting on top of the landlord’s retained Cat A, to go inside the contractor’s own tender pack.

Method

How it was measured and priced.

Measured, not assumed

Two take-offs — 111 items in 14 groups on the office floor, 45 items in 18 groups on the social floor — calibrated to the drawing and cross-checked against the brochure’s schedule of areas.

One backbone, three touchpoint ladders

Strip-out, alterations, electrical, data, HVAC, fire alarm, plumbing, surveys, CDM and preliminaries priced once and applied to every tier. Only joinery, kitchens, finishes, blinds, acoustics, signage, feature lighting, security and AV flex between tiers.

Regional pricing done properly

Materials priced nationally. Labour carries the central London uplifts and nothing else — applied retroactively to 76 items after the first pass got it wrong, and written down afterwards as an absolute rule.

Margin by section type

Pre-construction, M&E, fabric and finishes each carry their own margin band rather than one blanket percentage, so the differences between tiers reflect what the occupant actually sees and touches.

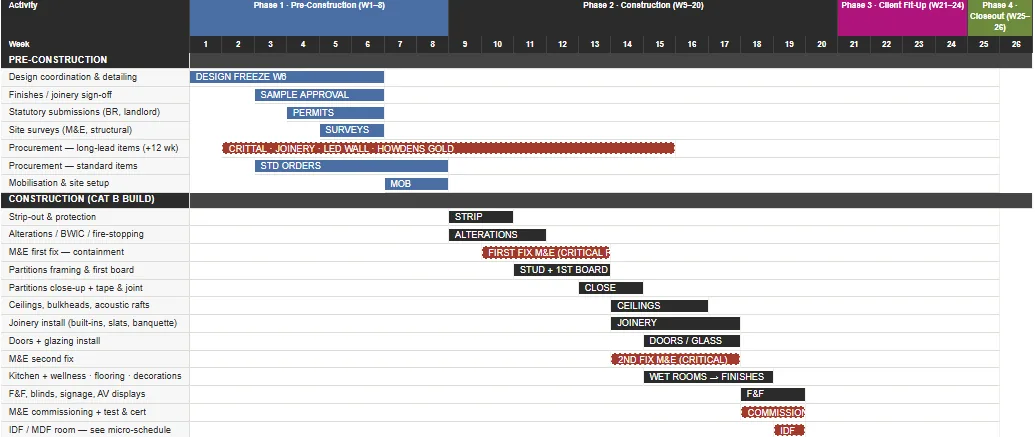

26-week master programme Gantt chart showing pre-construction, construction, client fit-up and closeout phases with the M&E critical path marked
The 26-week master programme — long-lead procurement and the M&E critical path called out. Added at the contractor’s request the day after the pack was issued.

What It Caught

The things that would have eaten the margin.

01

A demise wall nobody had drawn

On neither layout. A 60-minute wall of roughly 30 metres separating the demise from the rest of the plate.

How it was carried

Priced in full and stated as a credit-back if the landlord delivers it, so the contractor could answer the question either way without re-pricing.

02

No comms room on the social floor

The office floor shows an IDF/MDF store; the social floor shows nothing at all. Cooling and UPS for it unresolved.

How it was carried

Carried as a named allowance and listed on the tender-pack notes page as a clarification, with an option to resolve.

03

AV scope creep

A ‘full AV’ reading of the layouts would have added six figures at the top tier before anyone had asked for it.

How it was carried

Scoped to display-only across all tiers, with the full-AV delta stated separately so the client could choose it consciously.

04

Base-build assumptions with no specification behind them

No spec was issued, so ceiling heights, exposed soffit, chilled beams, integrated lighting and raised floor were all inferred from renders and the brochure.

How it was carried

Every assumption written onto one page of the report, with fallback allowances for asbestos R&D and structural condition if the landlord’s surveys did not materialise.

05

Twenty provisional sums

Strip-out contingency, reception desk, logo joinery, acoustic rafts, Cat A lighting, fire, HVAC and BMS modifications, soil stack, distribution pipework.

How it was carried

Set out as their own register with a ‘why provisional’ column, rather than buried inside a line rate.

06

Quantities that could only be rules of thumb

Without a specification, skirting lengths and pattressing heights had to be estimated by rule of thumb.

How it was carried

Flagged as exactly that on the notes page rather than presented as measured.

Delivered

What went into the tender pack.

A 22-page tier comparison report

Contents, at a glance, building and floors, scope in and out, how the tiers work, nine tier-ladder pages, the tier-neutral backbone, cost summary, £/m² ladder, industry benchmark, provisional sums, clarifications, pre-tender options, assumptions and exclusions.

An 18-page project programme

26 weeks in four phases, with site logistics, street-view approaches, sustainable delivery, master Gantt, floor-plate zoning, an IDF micro-schedule, punch list, long-lead register, acceleration strategy and health and safety.

Three live quotes

One per tier, around 310 lines each, structured three deep — section to floor to item — and clickable straight from the report.

Five bookable options

Motorised blinds, a solid-timber bleacher, broader acoustic treatment, additional wallcovering and games equipment, each with a stated add.

Page mosaic of the 22-page tier comparison report, blurred so layout and scale are visible but no text is legible
The 22-page tier report — pages blurred, layout only.
Page mosaic of the 18-page programme addendum, blurred so layout and scale are visible but no text is legible
The 18-page programme addendum — pages blurred, layout only.

Outcome

Pack issued and the fee billed. No award is recorded in the working files, so we are not claiming one — and on a budget exercise of this kind the pack often sits inside a wider tender whose result comes back months later.

What We’d Say to the Next Contractor

Two drawings and a brochure are enough to price a Cat B job properly — provided every assumption is written down where the client can see it.

Anonymised by design. Region and value band only — never a client, an address or a tender total. Drawings are reproduced with title blocks removed, and delivered packs are shown as blurred page mosaics so the scale and structure are visible and none of the content is legible.
